Modelling

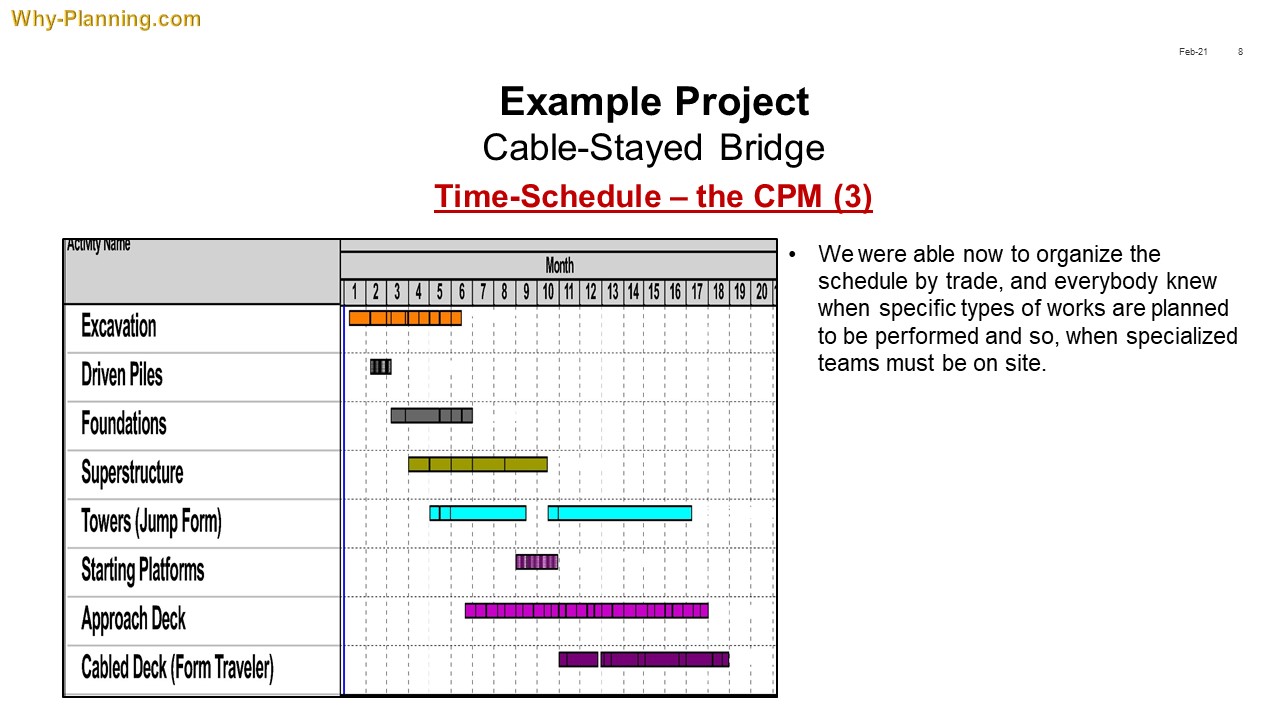

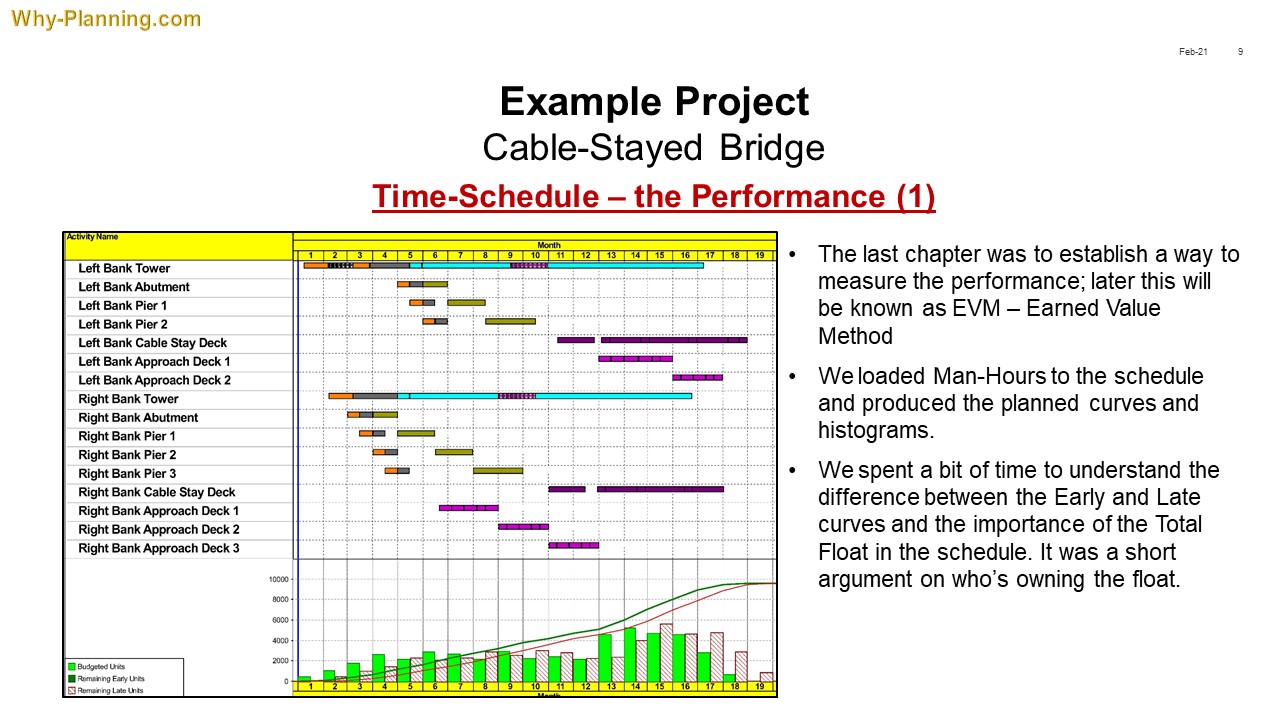

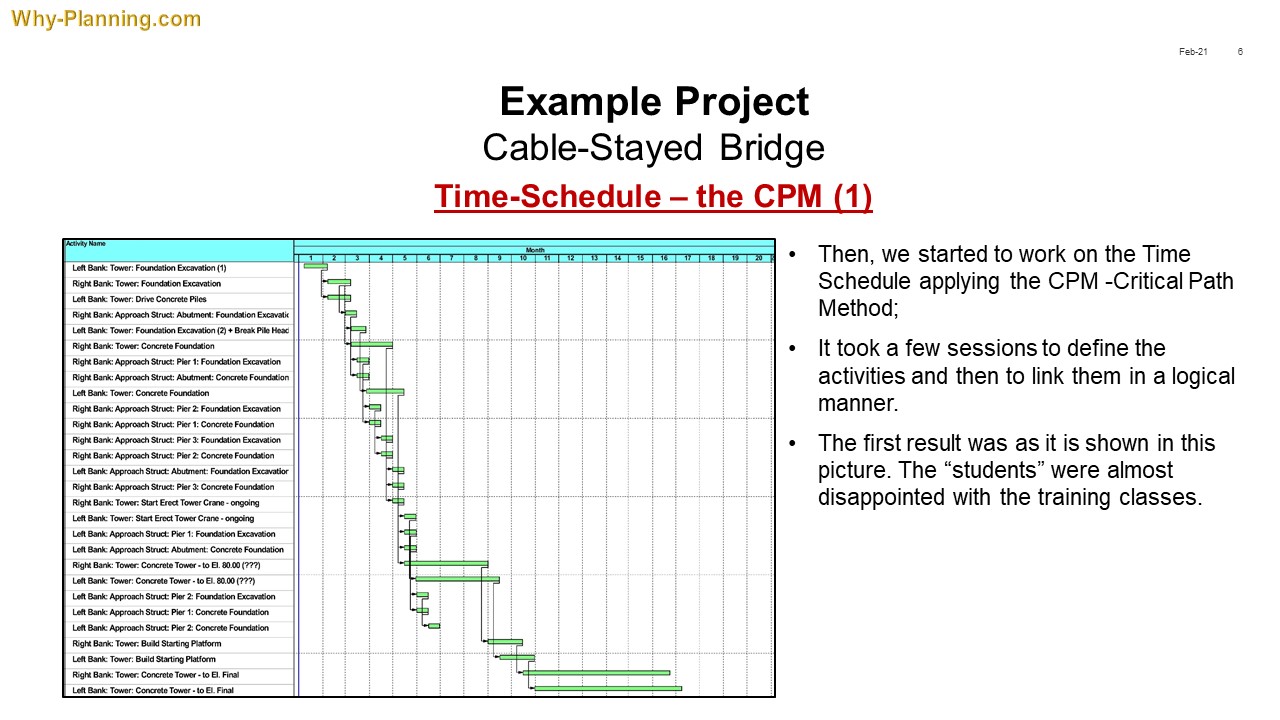

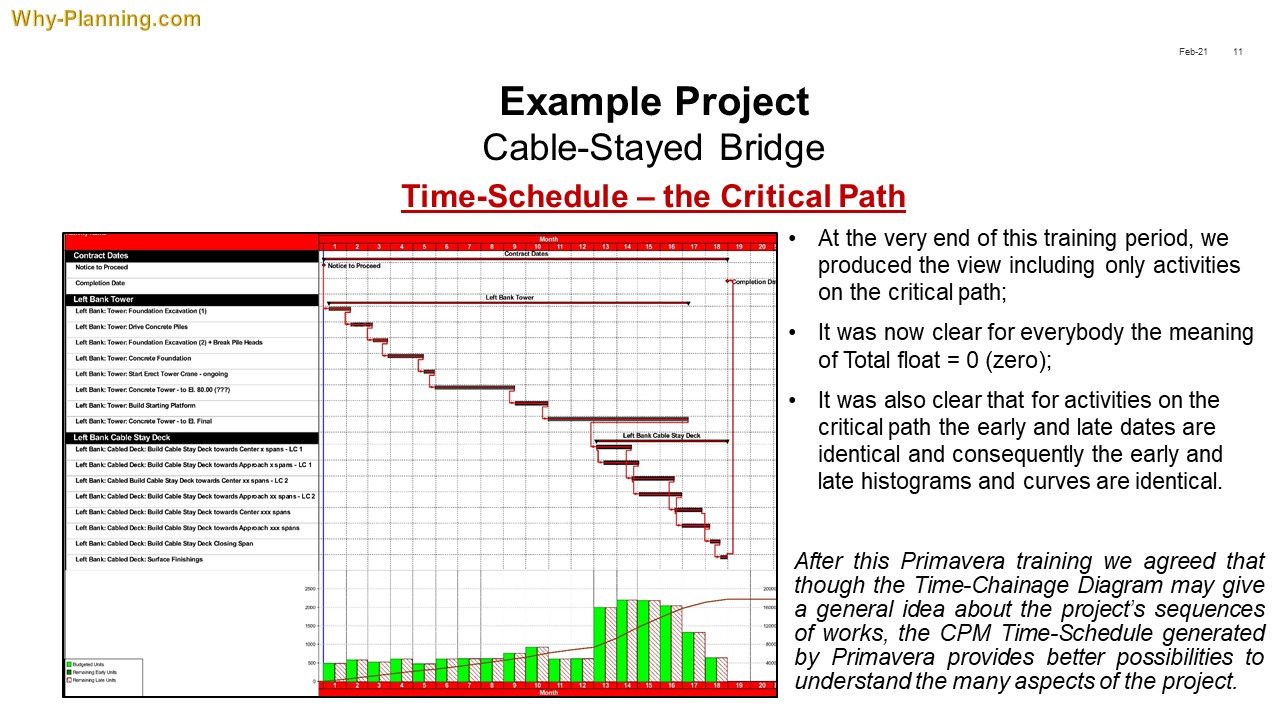

The planner is responsible to produce a time-schedule that reflects exactly the way the project has to be be build. Moreover, the planner is responsible to create a time-schedule easy to understand by all stakeholders and easy to convey information to all involved parties. The planner is responsible to design the model of the project. All is described in the presentation below. I choose as an example a Cable Stayed Bridge project, inspired by the Centennial Bridge over the Panama Canal in Panama.

Please be aware of the following:

– The time-schedules used to support my explanation are very schematic; the aim was that the content has not to exceed one page;

– The content of (almost) each sheet is presented in two areas: (1) pics, bar charts, curves etc. and (2) narrative description. It is advisable that you pay equal attention to both these areas as they contain complementary information.
